6 phases to master the SAP development process for modern enterprise software

Last updated: 22 Sep, 2026 Long Ho 15 mins read
Summarize article with AI

Key takeaway

  • SAP development process follows 6 structured phases under SAP Activate Methodology: Discover, Prepare, Explore, Realize, Deploy, and Run, replacing the older, rigid ASAP methodology.
  • Choosing the right SAP development methodology upfront determines project speed, risk, and how well the system scales after go-live.
  • The Clean Core philosophy keeps custom development off the S/4HANA core, using in-app or side-by-side extensibility on SAP BTP, to avoid the technical debt that historically made 91% of organizations' custom code a barrier to future upgrades.
  • A resilient SAP development roadmap accounts for AI tools like Joule for Developers and weighs migration risk (brownfield vs. greenfield) before locking in a timeline.
  • Common pitfalls, poor data migration, weak change management, and scope creep, cause most SAP projects to run over budget or behind schedule; governance and phased quality gates prevent this.

According to ASUG and Pillir's market research, enterprises spend $800,000 on average a year maintaining their most valuable custom SAP code alone. We see the cost. Needing SAP development doesn't mean accepting any custom development that gets the job done. Your business logic touches every module, role, and approval chain already running in SAP, so satisfying that need starts with governance, and only then comes code.

The SAP development process is the structured engineering workflow of designing, coding, configuring, and integrating custom business logic within an enterprise ERP landscape. It operates as the technical build layer beneath SAP governance. A standardized SAP development roadmap prevents custom code bloat, eliminates technical debt, and keeps software extensions aligned with core ERP operations

SAP development process follow a fixed sequence, and the order matters. That raises practical questions: how many SAP development phases modern enterprise software requires, which SAP development model fits a given project and how AI copilots like Joule are reshaping realization. This article breaks down the six development phases based on the SAP Activate Methodology: Discover, Prepare, Explore, Realize, Deploy, and Run.

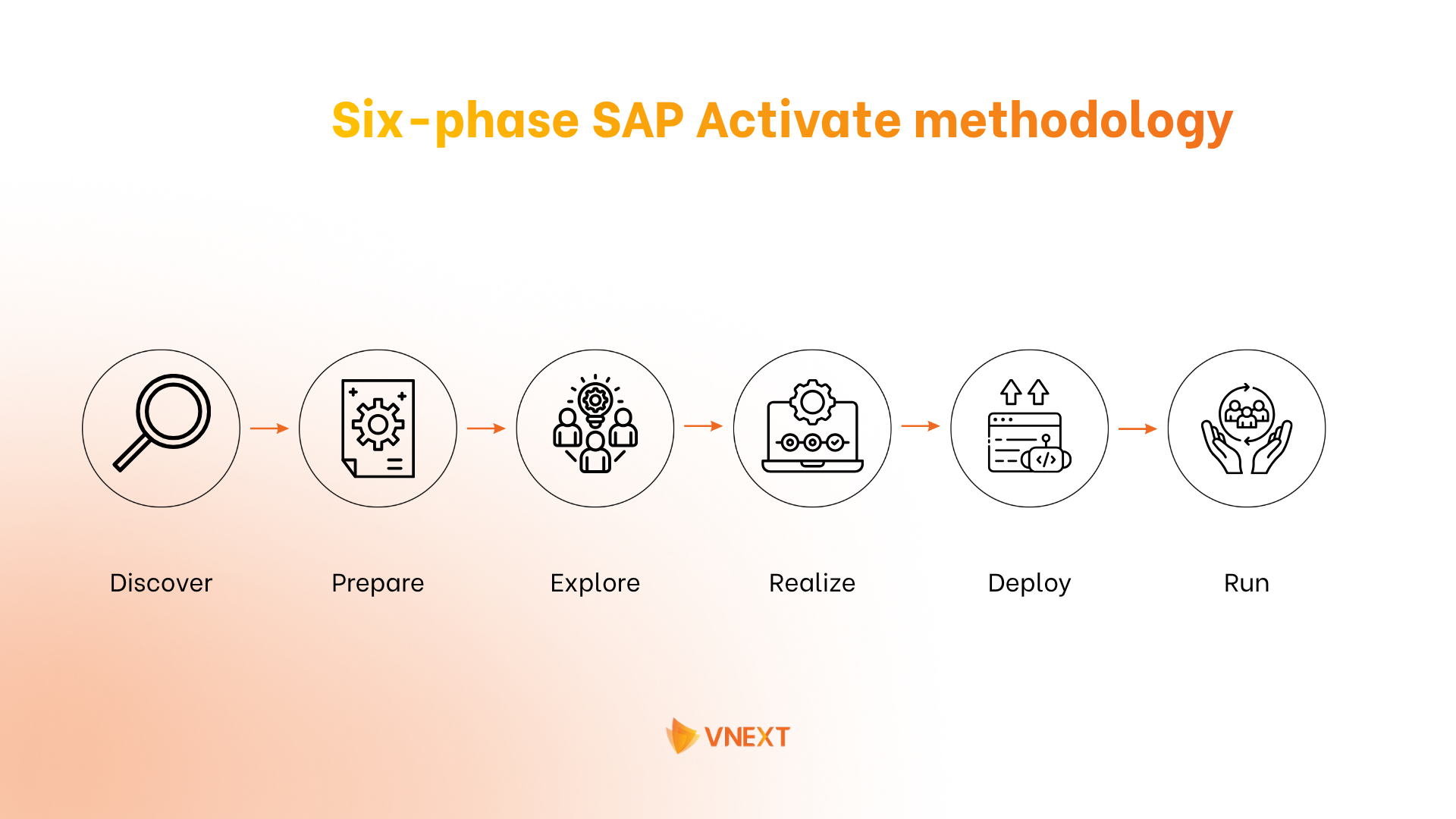

6 phases to master the SAP development process for modern enterprise software

Phase 1: Discover - Build your business case and define project scope.

The Discover phase is where an SAP journey starts, not with a technology pick, but with a clear answer to a harder question: is SAP the right move for your business, and which SAP development model fits it best? This is pre-project work. Nothing gets built yet.

A handful of documents end up carrying the rest of the SAP project on their back: a project charter, a business case backed by real ROI figures, an initial fit-gap analysis, an IT landscape assessment, and a risk assessment. For cloud projects, add a Digital Discovery Assessment to that list, SAP's mandatory tool for mapping the transformation before anything gets scoped in detail.

In this phase, two mistakes show up more than any others. First, sponsorship fades. In the SAP Success Report, a survey of 113 SAP professionals across 105 organizations, 45% said executive sponsorship was weak or inconsistent throughout delivery. Second, SAP gets treated as an IT upgrade instead of a business transformation. Prosci's 2025 unlocking ERP implementations study found human factors matter roughly 6 times more than technical ones in determining ERP outcomes, a fairly direct explanation for why rushed discovery and weak change planning cause more damage than any coding decision made later.

Discovery typically runs 2 to 4 weeks. Done properly, it saves months of rework further down the line.

Core objectives include:

  • Scoping the project and defining business goals
  • Building the business case and quantifying expected value
  • Assessing the current IT landscape and system readiness
  • Selecting the right implementation approach
  • Identifying stakeholders and locking in executive sponsorship

Phase 2: Prepare - Kick off project planning, onboard the team, and provision lifecycle management tools

Somewhere between the ambition set in Discover and the code that gets written in Realize, someone has to decide who is responsible for what. That's the entire job of Prepare: turning a vision into an organized structure of people, environments, and rules before the real technical work begins.

Governance tends to get treated as paperwork, but it's closer to insurance. A RACI matrix, a steering committee, and an escalation path exist so that when a decision needs to be made under pressure, everyone already knows who makes it. The same logic applies to the 4-in-a-box model, pairing business, IT, the implementation partner, and SAP so accountability doesn't quietly collapse onto whichever team happens to be loudest in the room.

There's a reason this is more important than it looks. ISG's State of SAP Migrations report found that nearly 60% of SAP migrations run over budget or behind schedule, and pinned most of that on weak governance rather than technical failure. In other words, the projects don't usually break in later phases. They break here, quietly, weeks before anyone notices.

This step usually takes 4 to 6 weeks, and its entire value shows up later, in how smoothly, or roughly, the later phases run. By the time this phase ends, a few artifacts need to exist:

  • A detailed project plan and finalized project charter that define who does what, and when
  • A governance structure and decision-making framework that guides how risks get managed and progress gets tracked
  • A system landscape covering development, QA, and production, the technical environments build work depends on
  • A fit-gap template Explore will rely on immediately

Phase 3: Explore - Fit-to-standard analysis for preconfigured processes

Explore is where a solution moves from assumption to validation, tested directly against how SAP works instead of being designed from a blank page. Fit-to-standard (F2S) workshops walk through SAP's best-practice scope items one by one, including preconfigured Joule Agents and Joule Assistants, and check each one against the real business process to see what fits and what needs to be flagged for further discussion.

Ask "Can the process change?" before asking "Can the system change?". Every gap closed through configuration instead of custom code is one less object to test, migrate, and maintain later. Custom code has a real, measured cost on the other side of that choice: research from ASUG and smartShift found that 58% of organizations name custom code as a direct barrier to future upgrades or migrations, and 39% call it a source of excessive maintenance cost.

Every gap that survives fit-to-standard still needs a deliberate destination, not whichever option happens to be easiest. In-app extensibility handles small changes a key user can make without deep technical involvement, while side-by-side extensibility on SAP BTP fits anything that needs to stay clear of the S/4HANA core, keeping the system easier to upgrade and aligned with SAP's Clean Core approach. Third-party integration makes sense when a separate system already solves the problem, and deep customization stays the last resort, used only when nothing else closes the gap.

Core objectives of this phase include:

  • Run fit-to-standard workshops across every business process, including Joule Agents and Joule Assistants
  • Pinpoint the required scope items from SAP Best Practices
  • Confirm configuration values and record delta requirements
  • Decide how functional gaps get resolved
  • Lock the technical design for integrations and extensions

Phase 4: Realize - Enrich your data and build and test the solution

The Realize phase turns what Explore mapped out on paper into a working solution, tested against real business scenarios instead of best-case assumptions.

Our team at VNEXT works in short sprints, typically two weeks each, with a clear scope and a working increment delivered at the end of every cycle. The goal is fast feedback: catching a configuration decision that doesn't hold up in week two, instead of finding out in week twelve.

Testing carries most of the risk in this phase and the research backs that up. A study comparing SAP testing approaches, Next-Generation SAP Testing with Cloud ALM, found that projects using integrated lifecycle management tools caught more defects before go-live, while teams using Excel-based testing saw more defects show up after go-live. We test in various layers: unit tests check each component, integration tests check how modules work together, and UAT lets business users confirm the solution actually works for them. Skip a layer and the defect doesn't go away. It just shows up at go-live instead, where it costs more to fix.

Data migration runs in parallel with configuration, with multiple test cycles checking quality and completeness before cutover. Training also takes place in this phase.

Key priorities in this phase:

  • Build and configure the solution in sprints
  • Develop the extensions, interfaces, and integrations scoped in Explore
  • Run unit, integration, and UAT testing
  • Test data migration alongside configuration
  • Kick off training and onboarding early
  • Lock in the change management plan

Phase 5: Deploy - Final setup, go-live, and user adoption support

Deploy is where every plan from Discover, Prepare, Explore, and Realize either works or it doesn't. SAP deployment covers final testing, the last data move, getting users ready, and the shift from project work into live support, all packed into one cutover weekend where a single delay can throw off everything that comes after it.

Cutover planning needs to start back in Realize instead of the week before go-live. Practice runs matter just as much as the plan itself. Run a full mock cutover using real-looking data and the same task order you'll use on the actual day, and you'll find the gaps a written plan can't show you on its own: timing clashes, missing steps, a task that quietly takes twice as long as anyone expected.

Hypercare starts the moment the cutover ends. It needs a clear shape rather than a loose promise of "extra help." Gartner's research on ERP go-live treats hypercare as its own phase with clear end points. It's not a fuzzy stretch that fades out whenever the team stops paying attention. Most projects run this window for 2 to 4 weeks. Setting those end points early, steady error rates, and a manageable list of open tickets, keeps hypercare from quietly dragging on for months.

Watch both the tech side and the business side here. A system can run well on paper while the people using it still don't trust it.

Core objectives include:

  • Run the cutover plan with zero data loss
  • Move and check final production data
  • Shift business operations onto the live system
  • Turn on hypercare support for fast issue fixes
  • Confirm every stakeholder is ready for go-live

Phase 6: Run - Maximize solution value by continuing adoption

Run is the last phase of the SAP Activate lifecycle, and it works differently from what came before it: the first five SAP development phases track progress against a go-live date, while Run tracks progress against adoption, uptime, and whether the business is getting the value it planned for back in Discover.

Monitoring should run continuously through tools like SAP Solution Manager or SAP Cloud ALM, catching issues before they reach the people trying to close month-end or process an order. Adoption needs the same attention: regular user feedback, quick fixes for pain points, and a real process for turning that feedback into a prioritized enhancement backlog.

The risk here is bigger than most teams expect. Gartner research found that more than 70% of recently implemented ERP initiatives will fail to fully meet their original business case goals by 2027, a gap that comes down to what happens after go-live more than the technology itself. Besides, SAP also launches new capabilities quarterly, and organizations with a process for evaluating those releases keep their systems updated.

This phase focuses on these objectives

  • Shifting from project mode into operational support
  • Tracking system performance and user adoption
  • Resolving issues and pushing continuous improvement
  • Unlocking innovation through new capabilities
  • Measuring and reporting business value

Choosing the right SAP development methodology for enterprise agility

Here's my advice: don't just use whatever development model your last project used, because the SAP development model you pick affects your speed, your risk, and how well the system holds up years later. Old frameworks ran in a straight line, each phase finishing before the next started, while modern teams now choose agile SAP development models built on steady checks that catch problems in weeks instead of at go-live.

The evolution of SAP Activate: why Agile frameworks replaced the classic ASAP framework

ASAP ran SAP projects for two decades through the same fixed sequence: project preparation, blueprint, realization, final preparation, go-live, each step needing to finish before the next began. SAP dropped that development method for SAP S/4HANA implementations, and the change was real, not just a new name.

SAP Activate rebuilt the SAP development methodology around three parts: SAP Best Practices, ready-made processes from thousands of past projects; Guided Configuration, tools to set up the system against those best practices; and an Agile development method that swaps blueprint-then-build for fit-to-standard workshops and short sprints.

Clean Core philosophy: protecting your ERP core with side-by-side extensions on SAP BTP

Moving fast without rules just brings the old problem back faster. ASAP-era projects packed years of custom code into the core, and every update afterward turned into a slow job. The Clean Core philosophy keeps a modern SAP development methodology from repeating that mistake.

The idea is simple: build extensions away from the S/4HANA core, through in-app extensibility for small changes, or side-by-side extensibility on SAP BTP for bigger ones, connecting to S/4HANA through open APIs instead of touching core code, so future upgrades stay light under any SAP development model.

Building a SAP development roadmap for 2026: Where AI tools and migration risk decide your timeline

A SAP development roadmap isn't a wishlist of features. It's the sequence that decides which risks get handled early, at low cost, and which ones get pushed into production, where they cost far more to fix. Two forces are reshaping how enterprises plan a SAP development roadmap right now: AI tools that speed up coding, and the migration decisions that determine how much technical debt a team carries into the new system.

AI and Joule for Developers

Joule for Developers now runs inside the ABAP development environment itself, built into the same tools developers already use. It offers predictive code completion as developers write. It explains existing ABAP and CDS code, so nobody has to reverse-engineer someone else's work. It generates unit tests automatically, a step that often gets skipped under deadline pressure. SAP built it on a large language model trained specifically on SAP code, which is why the suggestions are ABAP-specific instead of generic.

For a development roadmap, this changes what "fast" actually means. Teams that build Joule into sprints from the start move through the Realize phase with fewer hours spent on repetitive coding and more spent on business-specific logic. It's worth planning for early.

S/4HANA migration risk mitigation

The biggest risk on most SAP development roadmaps isn't a late feature. It's a migration approach chosen for speed that quietly drags old problems forward into the new environment. A Horváth study surveying 200 executives across six countries found that more than 60% of S/4HANA transformations run over budget, over schedule, or both, with projects taking on average 30% longer than planned. The leading causes cited were scope expansion mid-project, weak project management, and underestimated testing and data migration phases.

A resilient SAP development roadmap weighs brownfield against greenfield against a hybrid migration approach before locking in a timeline, instead of defaulting to whichever looks fastest on paper. Naming that choice explicitly, with a clear reason behind it, holds up under scrutiny. Treating the migration approach as a detail to sort out later doesn't.

Common challenges in SAP development

SAP development in enterprise landscapes always comes with surprises. Business logic has usually sat inside the system for years, shaped by undocumented processes and held together by workarounds nobody wanted to touch. Push a real development phase against it, and cracks appear fast. Some pitfalls are technical, others trace back to broken governance, and a few come down to people and adoption. These are the 3 we see most often.

  • Poor data migration: It's tempting to carry every legacy record into the new SAP system so nothing feels lost. In reality, it usually backfires. Messy source data, free-text dates, mismatched product codes, duplicate customer records, turns a straightforward data migration into a risky one, and large volumes on top of that slow the system and complicate validation. Move the data teams actually need for day-one business, and archive the rest. One duplicate customer record left in can split orders across two accounts for weeks after go-live.
  • Weak change management: SAP systems touch every department, finance, operations, sales, and each one adopts the new process at a different speed. That gap is easy to miss. Roles stay unclear, business rules don't get written down, or training gets rushed, and nobody notices until people stop using the new system after go-live. Building change management into the project early, not after go-live, is what catches this. Wait too long, and you may find users have quietly gone back to spreadsheets because they never trusted the new reports.
  • Scope creep and transport conflicts: SAP projects run through several workstreams at once, different developers, different modules, with transport requests moving through DEV, QA, and production at the same time. That setup is easy to break. One more requirement gets added mid-sprint, or two changes hit the same object and nobody catches it until testing. Locking scope early and tracking transport dependencies closely is what stops this. Catch a conflict at cutover instead, and the fix now competes with the go-live clock.

Wrapping up. Partner with VNEXT for SAP development success

At VNEXT, we know SAP development is a high-stakes build. It demands both deep technical precision and a working knowledge of how the business it supports runs day to day. Our teams have delivered SAP development work across the full Activate lifecycle, from Discover through Run, refining an approach built to lower risk at every phase, keep the system aligned with SAP's Clean Core principles, and get new capabilities into production without dragging technical debt along with them. We work with you through the entire journey, from fit-to-standard workshops to go-live and the hypercare weeks that follow.

Here's what a partnership with VNEXT brings to your project:

  • Certified SAP consultants delivering against ISO 27001-aligned security and governance standards
  • End-to-end development coverage, from ABAP Cloud and CDS extensions to integration and transport management
  • Clean Core-compliant builds that keep the S/4HANA core upgrade-ready instead of locked into custom code
  • Structured hypercare and post-go-live support that stabilizes systems instead of leaving them to self-correct
  • A single team of SAP developers, functional consultants, and project governance specialists working from one plan

If an SAP development project is on your roadmap, let's talk about building it right the first time.

Long Ho
Long Ho

Project Manager | ERP Solutions Consultant

Long Ho heads enterprise solution delivery at VNEXT, focusing on helping Japanese clients modernize their core business processes across CRM, ERP, logistics, and other business systems. With over 7 years of experience, he has grown from a full-stack developer into a Project Manager and Tech Lead, combining deep technical expertise with strategic leadership and client communication. Responsible for overseeing enterprise-scale projects of varying complexity, Long leads teams of up to 20 engineers through requirements analysis, architecture, development, and quality assurance, delivering tailored solutions that stay on schedule and within budget. He puts specific focus on aligning each solution with client objectives, mentoring developers and raising engineering standards along the way. Long also works with AI-assisted engineering, holding a Cognitive Engineering Level 6 certification, and integrates AI tools into his team's development workflow to strengthen how they build.

Let's talk

Ready to get results?
Our team is here to help.

Reviewed on Clutch 3 REVIEWS
  • AI Development
  • Custom Software Development
  • Mobile Application Development
  • Web Application Development
  • Cloud Development
  • Blockchain
  • Embedded Software
  • Enterprise Software
  • SAP
  • CRM
  • Data & Analytics
  • IT Outsourcing
  • Offshore Development Center
  • Dedicated Development Team
  • Staff Augmentation
  • I'm not sure / I need consultation
  • Automotive
  • Education
  • Energy & Environment
  • Enterprise Software & DX
  • Entertainment & Media
  • Finance
  • Gaming
  • Healthcare
  • Manufacturing
  • Professional Services
  • Retail
  • Transportation & Logistics
  • Travel & Hospitality
  • Others
