SAP implementation in manufacturing: What consultants wish you knew before kickoff

Last updated: 14 Oct, 2026 • Long Ho • 14 mins read
Summarize article with AI

Key takeaway

  • Early wins come from clean master data, clear process mapping, and a defined scope. Advanced modules and AI can wait until the core runs well.
  • Choose the right deployment model (public cloud, private cloud, or on-premise) based on how much control and customization your plant needs.
  • Settle the key design decisions early, like MRP Live versus PP/DS or embedded versus decentralized EWM, since they shape cost and complexity for years.
  • Most projects run 6 to 18 months and follow the SAP Activate phases, with go-live timed around production to avoid costly downtime.
  • With SAP ECC support ending in 2027, starting early gives you time to clean up data, train your people, and migrate without pressure.

SAP implementation in the manufacturing industry is the process of setting up and tailoring SAP to run a factory’s core operations, covering process design, master data preparation, shop-floor integration, and user training. It usually follows the SAP Activate methodology and runs from a few months to a few years, depending on project scope.

According to Panorama Consulting’s ERP Report, a large share of ERP projects run over budget or past schedule, and the cause is rarely the software. Far more often, it is due to poor data quality, weak change management, and a rushed approach. In manufacturing, this plays out in familiar ways: teams begin an SAP implementation without a clear plan for their data, processes, and workforce, then hit problems like messy master data, outdated custom code, and workflows that don’t match the plant production.

The better path is a well-planned SAP implementation that covers everything from early discovery and data cleanup to go-live and long-term support. In this guide, I’ll cover what makes SAP implementation in manufacturing succeed, from the early decisions that shape the outcome to the practical steps that keep delivery on schedule.

What SAP manufacturing implementation really involves?

SAP manufacturing implementation is more than installing one piece of software. It is the work of shaping SAP to run a factory end to end. In practice, a project pulls together six key parts:

  • Process design: mapping your production, procurement, quality, and finance processes against SAP best practices, and deciding where to standardize and where to adjust.
  • Master data preparation: cleaning and aligning BOMs, routings, work centers, material records, and vendor data.
  • Configuration: setting up core modules like PP, MM, SD, QM, PM, and FICO to match your plant.
  • Shop-floor integration: connecting SAP with MES, IoT devices, machines, and product lifecycle management (PLM).
  • Data migration and testing: moving data from legacy systems and validating real scenarios such as plan-to-produce and order-to-cash.
  • Training and support: preparing planners, operators, and quality and finance teams, then supporting the system after go-live with AMS and ongoing optimization.

Not every SAP implementation in manufacturing starts from the same place. A new implementation (Greenfield) builds SAP from scratch for a plant that is new to SAP or wants a clean start, while an ECC migration moves an existing SAP ECC system to S/4HANA, carrying over data, processes, and custom code. The two follow different paths and timelines, so knowing which one you are facing defines the whole project.

If you are moving off ECC before the 2027 deadline, see our full guide to SAP ECC to S/4HANA migration for manufacturing.

Is your plant ready for SAP implementation? A quick readiness checklist

Before committing to an SAP implementation, it is worth checking whether the right conditions for a smooth rollout are available, since a project that starts on a weak foundation is not likely to end well. Five things should be ready before the build begins: clean master data, clear process mapping, a defined project scope, a review of existing systems, and a plan for your people. The checklist below walks through each one.

1. You have clean master data

An SAP system is only as reliable as the data it runs on. Whether you are planning a full SAP implementation or an ECC migration, the quality of your master data decides how far the system can go. Reviewing your data readiness before scoping the build reduces rework and de-risks the delivery timeline.

In practice, that means your master data should be:

  • Stored in a form SAP can use, without heavy manual cleanup later;
  • Consistent in format and structure across plants and sources;
  • Current enough to reflect how your plant produces day to day;
  • Complete, covering the BOMs, routings, work centers, material records, and vendor data each module needs;
  • Free of duplicates and outdated records that spread errors into a fresh system.

2. You have mapped your processes

An SAP project works best when it is tailored to your factory’s operational processes. Manufacturers that enter implementation with their current processes clearly mapped, from order intake to shipping, move significantly faster than those who start configuring and work backward.

Detail beats assumption here. A clear picture of your real workflows, including the manual steps and the gaps where data gets lost, is far easier to fit to SAP and to scope accurately. Your teams don’t need to have fixed every process first, but they do need to agree on everyday workflow.

3. You have a defined project scope

An SAP project needs a clear specification from the start, one that defines which modules and plants go first, what counts as “done,” and where the boundaries are before configuring. Manufacturers that treat scope as an open-ended target tend to see timelines slip and costs grow as new requirements keep coming in. Before starting an implementation, confirm that the scope is written down and agreed on by both your team and your partner.

4. Your systems can support integration

SAP needs to connect with the other tools you use, both on the floor and in the back office, such as MES, PLM, warehouse systems, machines, and older software. Before you start an SAP implementation, check that these systems can share data with SAP through clear connection points like APIs or data exports. Getting this right helps you avoid one of the most common causes of delay in a manufacturing rollout.

Signs your integration layer is ready:

  • Core systems have documented APIs or accessible data exports;
  • Data ownership and access permissions are clearly defined;
  • IT and shop-floor teams are available to support integration work;
  • Security and compliance requirements for data sharing are understood.

If your current setup needs significant rework before SAP can connect, build that work into the implementation plan early.

5. You have a plan for your team

Before starting, confirm that your plant has a plan for the people who will use SAP every day: planners, operators, and quality and finance teams. That means naming process owners, preparing training early, and explaining what changes in daily work before go-live.

Get your factory SAP-ready and turn everyday data into faster decisions.

Reach out to VNEXT


Choosing your SAP deployment model

Manufacturers can run SAP S/4HANA in three ways, and the right choice depends on how much control, flexibility, and customization your plant needs. The table below compares the three deployment options: SAP S/4HANA Cloud Public Edition, SAP S/4HANA Cloud Private Edition & SAP S/4HANA On-Premise.

Criteria

SAP S/4HANA Cloud Public Edition (GROW with SAP)

SAP S/4HANA Cloud Private Edition (RISE with SAP)

On-Premise

Model

A shared SaaS model fully managed by SAP

A dedicated cloud with more flexibility, managed by SAP

Infrastructure owned and run by the manufacturer

Infrastructure and operations

SAP manages the full technical environment

SAP manages the infrastructure, with more control on your side

Your team handles infrastructure, security, backups, and operations

Customization

Follows Clean Core; extensions through SAP BTP only

More room for complex needs and legacy code, Clean Core still advised

Deepest control over system and custom code

Upgrades

SAP applies regular updates automatically

You control upgrade timing within SAP’s lifecycle

You fully manage upgrade planning and timing

Best for

Manufacturers standardizing processes, going live fresh, or scaling fast

Large manufacturers moving off SAP ECC with complex legacy systems

Plants needing full control over infrastructure, security, or strict compliance

Key manufacturing design decisions to make before you implement

An SAP implementation involves fitting SAP’s modules to plant production. The biggest strength is the ability to standardize processes, connect the shop floor to the back office, and run production on real-time data. But moving from strategy to a working system means making a few key design decisions, as listed below:

  • Production planning: standard MRP Live or embedded PP/DS? For simpler plants, MRP Live handles material planning fast on live data. For complex scheduling with many product variants, embedded PP/DS gives you finer control. Picking the right level early helps you avoid both over-engineering and under-planning.
  • Warehouse: inventory management, embedded EWM, or decentralized EWM? Basic inventory management covers simple stock handling. Embedded EWM suits plants that need bin-level control inside S/4HANA. Decentralized EWM fits high-volume, complex warehouses that run on their own.
  • Quality and traceability: how deep should QM and batch management go? Some plants only need basic inspections, while regulated industries like food and pharmaceuticals need full batch traceability and product history. Deciding how far QM and batch management should reach early keeps you compliant without adding effort you don’t need.
  • Shop-floor execution: S/4HANA production orders, SAP Digital Manufacturing, or a third-party MES? Simple operations can run on S/4HANA production orders alone. Plants that need real-time machine data, paperless work, and OEE tracking get more from SAP Digital Manufacturing. Some keep an existing third-party MES.

Making these decisions before the build begins keeps an SAP implementation on scope and on budget. An experienced partner can help you pick each one based on your production type, volume, and long-term goals.

“Honestly, I get why a lot of manufacturers feel nervous before an SAP project. It feels big. But most of what goes wrong comes down to a few early choices, your data, your scope, who owns what. Sort those out first, and the whole thing gets a lot less scary. That’s the part we love helping teams with.”

Long Ho - SAP Expert

6 SAP implementation phases in manufacturing (SAP Activate)

SAP recommends a six-phase approach called SAP Activate: discover, prepare, explore, realize, deploy, and run. The phases are the same across industries, but in a factory each one carries manufacturing-specific work that a generic rollout often misses. Here is what each phase looks like on the plant floor.

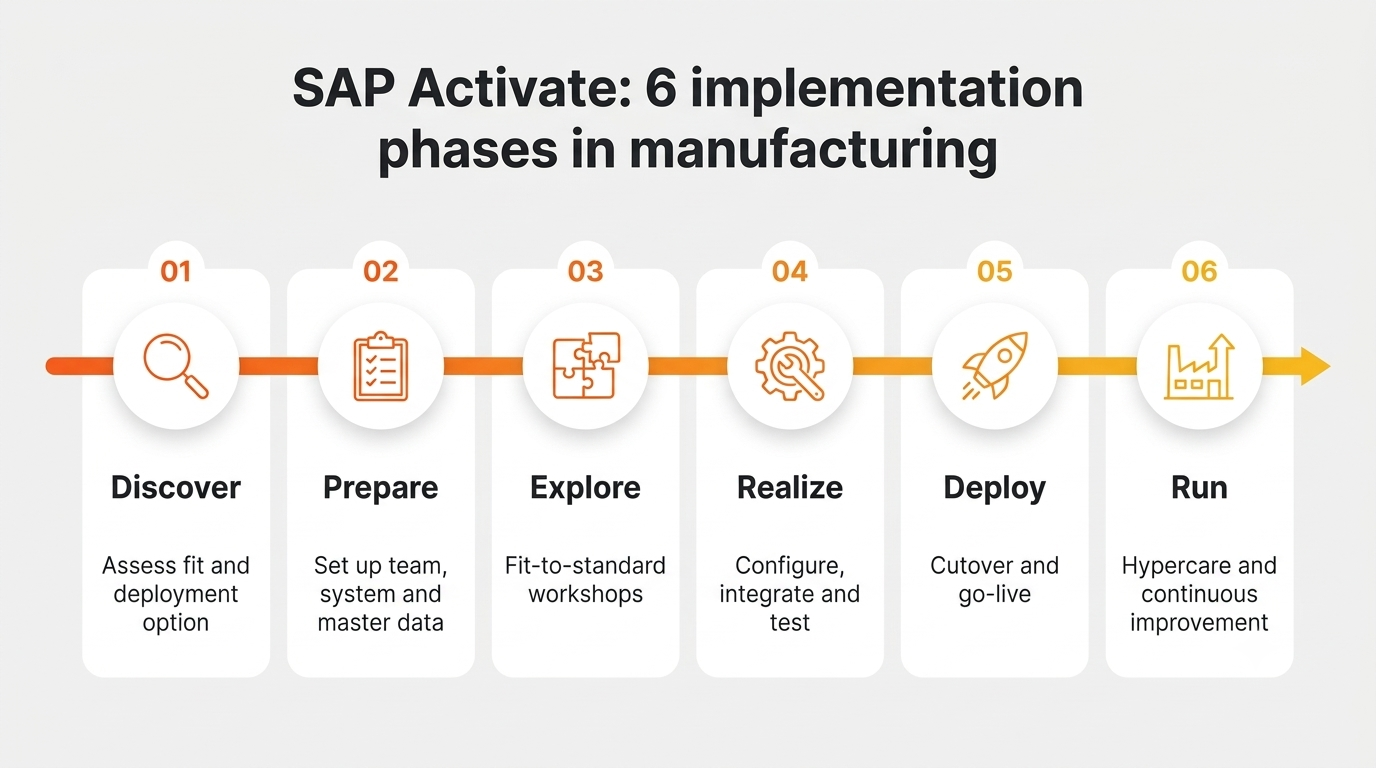

6-sap-implementation-phases-in-manufacturing-sap-activate

Discover

The “Discover’ phase is where you evaluate the level SAP fits your plant and decide on the deployment option, whether that is RISE with SAP, public cloud, or on-premises. On the factory side, this stage reviews your current production, quality, and maintenance processes and, for the many plants still on SAP ECC, weighs migration options ahead of the 2027 support deadline.

Key deliverables:

  • A high-level implementation roadmap
  • A defined scope of SAP modules to implement (such as PP, MM, SD, QM, PM, and FICO)
  • Access to a trial environment to test SAP Fiori and key features

Prepare

Once the direction is set, the preparation phase moves into practical detail: setting the rules and responsibilities for the project team, building the technical environment, and getting everyone aligned. This is also where master data work should begin, since BOMs, routings, work centers, and material records take time to clean up. Poor data quality is one of the leading reasons ERP projects run late, so starting early here protects the whole timeline. The project manager works closely with department heads, IT, and shop-floor leads to get the plant ready for what is coming.

Key deliverables:

  • A project charter with goals, roles, and responsibilities
  • A detailed project plan and timeline
  • An initial system technical setup
  • A master data cleanup and migration plan
  • A change management plan and kickoff materials

Explore

Through fit-to-standard workshops, your teams see how standard SAP processes run and identify the gaps between them and your current production processes. Key manufacturing design decisions get settled here too, such as MRP Live versus embedded PP/DS, or embedded versus decentralized EWM, with any gaps added to the project backlog.

Key deliverables:

  • A fit-to-standard assessment
  • A project backlog with gaps, technical requirements, and extensions
  • Confirmed process documentation for production, quality, and logistics
  • A solution scope sign-off
  • A financial business case with ROI and TCO

Realize

In this phase, the project team configures the core modules (PP, MM, SD, QM, PM, FICO) to fit your production processes, develops any custom extensions, migrates master data, and connects SAP to your MES, machines, and other systems. The work runs in sprints, and every work item is tested with real production scenarios like plan-to-produce and order-to-cash before it reaches the floor.

Key deliverables:

  • A fully configured system
  • Completed and tested custom developments and integrations
  • Migrated and validated master data
  • Documentation with test scripts and results
  • User training guides and materials

Deploy

The deploy phase is the final move to the live system, covering final data migration, system checks, and user training. Timing is the biggest concern at this point because the cost is real. According to the Siemens True Cost of Downtime 2024 report, unplanned downtime averages around $260,000 per hour across large manufacturers, and reaches $2.3 million per hour in automotive. A well-planned cutover keeps that disruption to a minimum.

Key deliverables:

  • A final cutover plan built around production schedules
  • Completed training for planners, operators, and quality and finance teams
  • A fully live production system

Run

With the system live, the focus shifts to keeping it stable and making it better over time. In the first few weeks, your partner should run hypercare support to catch and fix issues before they hit production. Once things settle, the plant can start adding newer tools like predictive maintenance, built-in analytics, and AI with SAP Joule.

Key deliverables:

  • Hypercare support for a short period after go-live
  • A formal operational readiness review
  • A continuous improvement plan
  • A post-implementation review and benefits tracking

Learn more about 6 phases to master the SAP development process for modern enterprises

How long does SAP implementation take in manufacturing?

Most SAP implementations in the manufacturing industry take between 6 and 18 months, though the exact timeline depends on your deployment model, the number of plants, the degree of customization, and the state of your data. A straightforward public cloud rollout can go live in a few months, while a large, multi-plant project with heavy customization can run well past a year, often 18 to 36 months.

Several factors push a manufacturing project toward the longer end of these ranges. Multiple plants or countries bring added localization and phased rollouts, or heavy custom code from an old SAP ECC system takes time to review and clean up. With SAP ECC support ending in 2027, and Gartner projecting that over 75% of SAP ECC customers will have started or completed their migration by 2027, starting early is the surest way to avoid a rushed project and a longer timeline.

How much does SAP implementation cost for manufacturers?

For manufacturers, SAP manufacturing implementation cost is driven by a few plant-specific factors: the number of plants, how much custom code carries over from an old SAP ECC system, the state of your master data (BOMs, routings, material records), and the integrations needed with MES, machines, and legacy tools. SAP does not publish fixed pricing for S/4HANA, so the figure depends heavily on your setup.

The cost usually breaks down into three parts:

  • Software licensing: priced per user per month for cloud editions, or as a perpetual license plus annual maintenance for on-premise.
  • Implementation services: usually the largest part of the budget, covering consulting, configuration, data migration, integration, and testing.
  • Ongoing costs: support, cloud hosting, and future upgrades.

Because SAP pricing is quote-based, the only reliable number comes from a scoped estimate by SAP or a certified implementation partner, built around your production type, module mix, and number of sites.

Conclusion: What a well-planned SAP project delivers

When an SAP implementation is done right, the results show up fast. A Forrester Total Economic Impact study of SAP S/4HANA Cloud found a 155% ROI, $4.8 million in benefits, and a 9-month payback for the organizations studied. Pretty significant for one system.

Sure, I can’t promise you’ll see the exact same numbers. Those results came from specific companies, and the details matter, at least not before we review your scope. The point still stands. When SAP is built on clean data, the right modules, and teams that are ready to use it, production runs smoother, decisions get faster, and the investment pays for itself.

If you want to check whether your plant is ready for SAP, we’ll walk you through what an implementation really involves, share similar manufacturing cases, review your processes and data, and help you design a rollout that fits your production setup, well before the 2027 ECC deadline forces the timing.

Long Ho
Long Ho

Project Manager | ERP Solutions Consultant | SAP Expert

Long Ho heads enterprise solution delivery at VNEXT, focusing on helping Japanese clients modernize their core business processes across SAP, ERP, manufacturing, logistics, professional services, and other business systems. With over 7 years of experience, he has grown from a full-stack developer into a Project Manager and Tech Lead, combining deep technical expertise with strategic leadership and client communication. Responsible for overseeing enterprise-scale projects of varying complexity, Long leads teams of up to 20 engineers through requirements analysis, architecture, development, and quality assurance, delivering tailored solutions that stay on schedule and within budget. He puts specific focus on aligning each solution with client objectives, mentoring developers and raising engineering standards along the way. Long also works with AI-assisted engineering, holding a Cognitive Engineering Level 6 certification, and integrates AI tools into his team's development workflow to strengthen how they build.

Let's talk

Ready to get results?
Our team is here to help.

  • AI Development
  • Custom Software Development
  • Mobile Application Development
  • Web Application Development
  • Cloud Development
  • Blockchain
  • Embedded Software
  • Enterprise Software
  • SAP
  • CRM
  • Data & Analytics
  • IT Outsourcing
  • Offshore Development Center
  • Dedicated Development Team
  • Staff Augmentation
  • I'm not sure / I need consultation
  • Automotive
  • Education
  • Energy & Environment
  • Enterprise Software & DX
  • Entertainment & Media
  • Finance
  • Gaming
  • Healthcare
  • Manufacturing
  • Professional Services
  • Retail
  • Transportation & Logistics
  • Travel & Hospitality
  • Others
