SAP ECC to S/4HANA migration for manufacturing: How to prepare your plant before the 2027 deadline

Last updated: 12 Oct, 2026 • Long Ho • 20 mins read
Summarize article with AI

Key takeaway

  • SAP ECC mainstream support ends on December 31, 2027. Manufacturers that miss the deadline must pay extra for extended maintenance, which only lasts until 2030.
  • SAP S/4HANA gives manufacturers capabilities ECC cannot, including real-time MRP, a single source of truth for inventory and finance, the role-based SAP Fiori interface, and built-in AI and predictive analytics.
  • The biggest manufacturing-specific challenges are custom scheduling logic, the WM-to-EWM transition, master data cleansing, batch traceability, shop-floor integrations, and cutover in 24/7 plants.
  • The migration decision should be made soon, since master data cleanup alone needs to start 12-18 months before go-live, and the pool of experienced SAP consultants is shrinking as the deadline approaches.

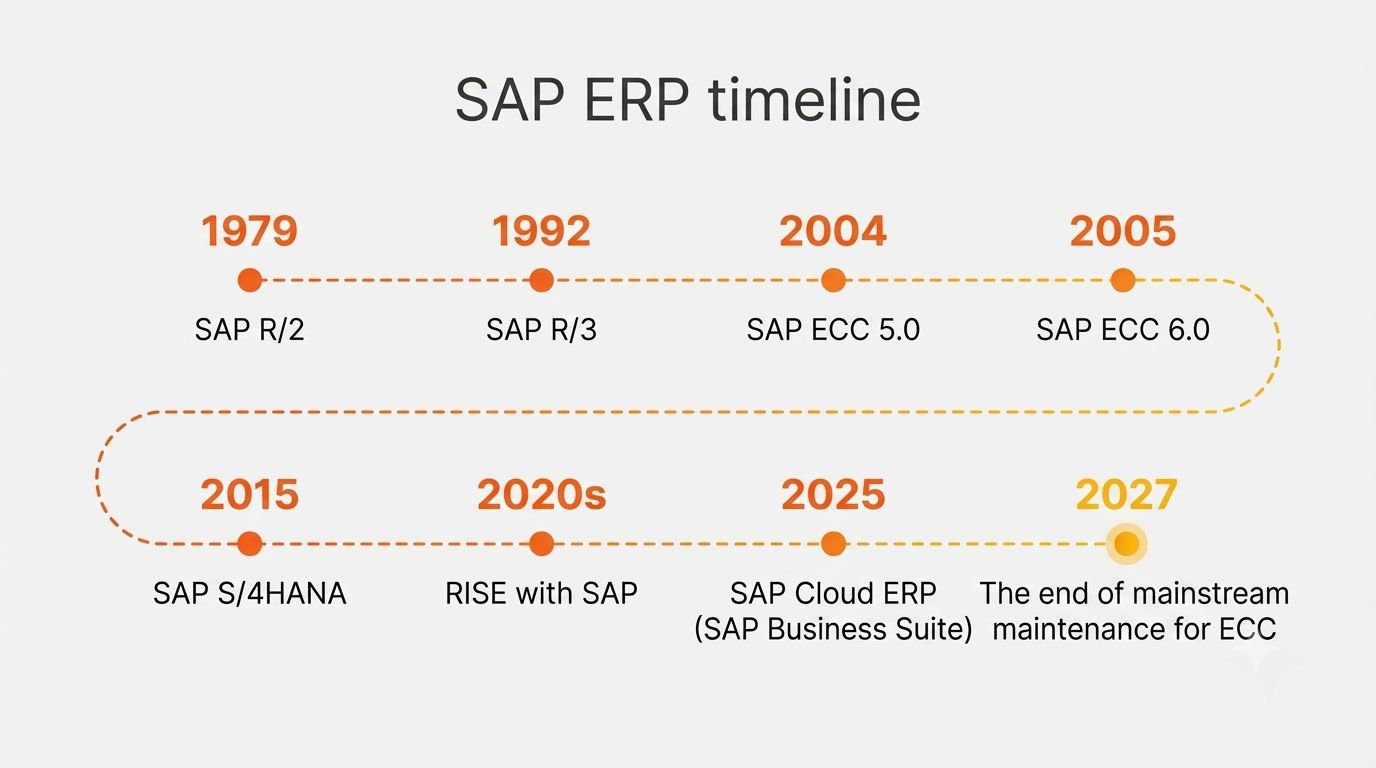

For almost 20 years, SAP ERP Central Component (SAP ECC) has been the ERP backbone for more than 35,000 businesses worldwide as of 2024, many of them manufacturers running their plants on it every day.

That is about to change. SAP has scheduled the end of mainstream support for SAP ECC on December 31, 2027, after which security patches, compliance updates, and fixes all stop, unless you pay for extended maintenance, which costs 2 to 3 times more and only buys time until 2030. For an ISO-certified plant, running an unpatched core system is a serious compliance and security risk.

Some may see the 2027 deadline as still far off. But migration takes time: the average SAP ECC to S/4HANA project runs around 1.5 years, and the pool of experienced SAP consultants keeps shrinking as more companies move toward the same deadline. The numbers show how slow the transition has been. According to the DSAG 2026 investment report, only 37% of companies still on SAP ECC expect to be live on S/4HANA by the end of 2027, while about half plan to finish by 2030 and pay extra for support in the meantime.

For manufacturers, waiting is the riskier choice, since a rushed migration often leads to resource shortages, higher costs, and disruption on the shop floor. In this guide, I’ll walk you through what the SAP ECC to S/4HANA migration involves for your plant, the approaches and steps, the challenges specific to the manufacturing industry, and how to prepare early so you can prepare your own schedule and avoid last-minute pressure.

What is SAP ECC and SAP S/4HANA?

SAP ECC (ERP Central Component) is SAP’s long-standing enterprise resource planning system. It connects data from finance, HR, sales, supply chain, and manufacturing, enabling production, procurement, and finance to run on one shared set of records. Introduced in 2004 as part of SAP ERP 6.0, it became the core of SAP's ERP suite and has served a large number of large manufacturers ever since.

SAP S/4HANA, launched in 2015, is the successor to SAP ECC. Developed for SAP's in-memory database SAP HANA, which arrived in 2011, it tackles long-standing problems of traditional ERP systems, such as batch latency and data sprawl. Because its applications run only on the HANA database, their advantages include simplified data models and a cleaner user experience through SAP Fiori, giving manufacturers real-time MRP, embedded analytics, and one synced view across the plant floor and the back office.

SAP ECC to S/4HANA migration is the process of moving a company's ERP from the legacy SAP ECC platform to SAP S/4HANA, including the data, processes, and custom logic that operate the business. This is more than a technical upgrade: a system conversion changes the underlying data model, simplifies decades of custom code, and reshapes how production, planning, and logistics work together in real time. When you migrate from ECC to S/4HANA, you are not just updating software; you are modernizing the digital core that runs the entire plant, and doing it before the 2027 mainstream support deadline is recommended.

What SAP S/4HANA offers manufacturers that SAP ECC doesn’t

While both systems handle core operations, they work very differently on the plant floor. The key differences are outlined below.

Category

SAP ECC

SAP S/4HANA

Data and decision architecture

Relies on traditional databases that separate transactional and analytical layers, which forces plant data to be copied to other systems for reporting.

Processes transactions and analytics together on live data in the HANA database, giving plant managers a real-time view of the floor.

Production planning (MRP)

Material Requirements Planning consumes heavy system resources.

With MRP Live running at the database level, the production plan updates in minutes and reacts to demand changes and supply delays as they happen.

Product costing and finance

Finance and Controlling run in separate modules, with cost data stored apart and matched by hand.

A single table visualizes all financial data, bringing real-time visibility into product cost, margin, and plant profitability.

Inventory transparency

Inventory data is spread across 26+ tables, which often leads to errors and mismatches between stock records.

Because inventory stays in one record, stock levels across plants and warehouses remain accurate and up to date.

Shop-floor user experience

Runs on SAP GUI, a transaction-code interface based on technical modules.

Offers SAP Fiori, a role-based interface that works on any device, from shop-floor terminals to mobile phones.

Process intelligence

Leaves users to spot errors, shortages, or production delays through static lists and spreadsheets.

Uses built-in machine learning to flag anomalies, automate routine data work, and recommend the next best action.

Future readiness

Limits innovation to bolt-on add-ons that complicate every upgrade.

Keeps a standard core and moves extensions to SAP BTP, allowing new technology without disruption to production.

Why do manufacturers need to migrate from SAP ECC to S/4HANA?

SAP S/4HANA is reshaping how manufacturers run their production processes, and plants that stay on SAP ECC risk falling behind. A plant that runs on unsupported software risks security gaps, compliance issues, higher migration costs later, and slower innovation.

Still, SAP ECC customers are not rushing to migrate. In line with the DSAG 2026 investment report, CIO, citing Gartner, reports that around 17,000 companies are still projected to remain on ECC by 2027, nearly half the customer base, and more than a third, roughly 13,000, will likely still run the legacy ERP in 2030. One reason companies postpone the move is simply not knowing what the end of support involves.

At the same time, SAP S/4HANA offers clear benefits: a unified data model, real-time MRP, and built-in machine learning that give manufacturers real-time insight into the plant and automated process intelligence. These capabilities help a factory stay flexible and efficient as the industry moves toward Industry 4.0.

So let's look at why it is worth reconsidering legacy SAP ECC, and how an SAP ECC to S/4HANA migration solves these issues for manufacturers.

Security and compliance gaps after 2027

When mainstream support ends on December 31, 2027, SAP stops issuing security patches for ECC. Any vulnerability found after that date goes unfixed, which is a serious problem for a factory. For ISO-certified plants, an unpatched core system can also break compliance and put audits, certifications, and customer contracts at risk.

What migration offers: SAP S/4HANA keeps the plant secure and compliant. It offers the latest security updates and automated regulatory patches, so your core system stays protected. Built-in AI functions add another layer, spotting unusual transactions or data patterns early, before they turn into a security or quality issue.

The rising cost of extended support

Staying on SAP ECC past 2027 is not free. Manufacturers that miss the deadline have to pay for extended maintenance to keep support running through 2030, with an incremental 2% in maintenance fees. For a large plant with a heavily customized system, that cost compounds fast while putting improvements on hold.

What migration offers: SAP S/4HANA lowers long-term costs through a leaner architecture. By removing the many unnecessary tables that SAP ECC carries, it can cut database size by up to half, which reduces infrastructure and maintenance costs. For manufacturers, that means paying less to run the core system and freeing up budget for improvements on the floor.

Falling behind on innovation

SAP is no longer building new features for ECC. Capabilities like AI assistants, predictive analytics, and modern data tools are going into SAP S/4HANA, so manufacturers who stay on ECC miss these developments for sure. The gap widens over time: as competitors adopt smart factory tools and real-time analytics, a plant frozen on ECC risks falling behind on efficiency, cost, and speed. The talent problem makes it worse, since the pool of ECC specialists keeps shrinking, which makes support harder to find and more expensive every year.

What migration offers: SAP S/4HANA brings intelligent enterprise capabilities built for modern manufacturing. With the SAP Joule generative AI assistant, teams can ask questions in plain language and reach insights up to 95% faster. Predictive analytics let planning and finance teams forecast demand and cash flow in real time, and each new SAP release adds more automation and AI, keeping your plant on pace with the rest of the industry.

Learn more about SAP S/4HANA for Manufacturing: Core modules, benefits and how to implement it

SAP ECC to S/4HANA migration approaches

There are three main approaches to SAP ECC to S/4HANA migration: Greenfield, Brownfield, and Bluefield. Each offers a different balance of modernization, risk, and effort, and the one you choose plays an important role in defining the project's cost, technical complexity, timeline, and the workload on your team. In a plant where downtime is costly and production cannot simply stop, this is a strategic decision as much as a technical one, since it affects how much of your existing setup carries over and how much the shop floor feels the change.

Greenfield: A fresh start on a new system

A greenfield migration builds a brand-new SAP S/4HANA system from the ground up and leaves the legacy environment behind, so a manufacturer can drop outdated custom code and obsolete processes and start again on SAP's standard best practices.

  • Suits plants ready to rethink outdated workflows, or companies moving off non-SAP systems or scattered ECC setups across several sites.
  • Puts the focus on clean, standardized processes and SAP best practices, not on carrying over old configurations and legacy logic.
  • Paves the way for radical transformation like real-time MRP, embedded analytics, and AI right from go-live.
  • Requires serious work to select, clean, and move master data such as BOMs, routings, and material records, and takes longer than a straight technical conversion.
  • Needs solid training for operators, planners, and quality teams, since daily work in the new system looks quite different from ECC.

Brownfield: Modernizing existing systems

A Brownfield migration converts the existing SAP ECC system to S/4HANA while keeping historical data, current configurations, and custom developments in place, so a manufacturer can modernize the core without rebuilding the processes that keep the plant running.

  • Suits a stable, well-run ECC environment that mainly needs to move to the new database and architecture, not a full redesign.
  • Keeps production data, proven workflows, and custom logic, preserving the institutional knowledge built up over years.
  • Offers the fastest and least disruptive route, with a quicker go-live for plants.
  • Needs careful pre-migration checks on custom code and data quality, since outdated Z-programs, redundant settings, and weak processes carry over if left unaddressed.
  • Delivers S/4HANA's benefits more slowly if that technical debt is not cleaned up first, which can delay real-time planning and analytics.

Bluefield: A hybrid option

A Bluefield migration mixes the two approaches above, building a new SAP S/4HANA system but moving only the data and processes a manufacturer chooses to keep, which makes it a strong fit for complex operations spread across several plants or regions.

  • Combines Greenfield and Brownfield, reimplementing some areas on fresh best practices while converting others to preserve what is working well.
  • Lets you clean up messy processes while keeping the production and compliance records you need for audits and traceability.
  • Allows a phased move, plant by plant or unit by unit, which reduces disruption across the whole enterprise.
  • Runs more complex to set up, since ECC and S/4HANA often have to coexist during the transition.
  • Demands strong technical skills and usually the support of experienced SAP partners to manage the selective data move.

Criteria

Greenfield

Brownfield

Bluefield

Cost

High

Medium

Medium to high

Timeline

18- 36 months

12 - 24 months

18 - 30 months

Business risk

High

Low to medium

Medium

Effort on your team

High, with new processes and full training

Lower, workflows stay familiar

Medium, varies by area

Historical data

Not carried over

Fully kept

Moved selectively

Process change

Complete redesign

Minimal

Partial

Legacy custom code

Clean start

Carried over, then fixed

Kept where it adds value

Best for

Plants ready to redesign old processes and start clean

Stable plants that need to keep all production and audit history

Multi-plant groups changing one site or unit at a time

Manufacturing-specific challenges of SAP ECC to S/4HANA migration

Manufacturing plants face a different set of migration constraints than other industries.

From my experience, I can single out SAP ECC-to-S/4HANA migration challenges in six areas that manufacturers deal with most often: production scheduling, warehouse management, master data, batch traceability, shop-floor integration, and cutover.

1. Custom scheduling logic vs. embedded PP/DS

In SAP ECC, many manufacturers use custom ABAP programs to handle what standard PP can’t, such as sequence-dependent setups, tool availability, and machine-specific cycle times. SAP S/4HANA includes embedded PP/DS, which covers some of these needs out of the box but requires new master data and setup rules. You will need to review each custom program and decide whether to replace it with PP/DS, rebuild it in ABAP, or switch to a third-party scheduling tool.

2. WM to EWM transition

Classic Warehouse Management (WM) is no longer SAP’s main warehouse solution in S/4HANA. You will need to choose between embedded EWM, decentralized EWM, or Stock Room Management. This change affects more than the warehouse: put-away, picking, material staging for production, and handheld (RF) processes on the shop floor all need to be redesigned.

3. Master data cleansing

Over the years, ECC systems collect outdated BOMs, unused routings, and incorrect work center data. In S/4HANA, production versions are required to select BOMs and routings, and customer and vendor records must move to the Business Partner model. If you migrate this data without cleaning it first, planning, costing, and MRP errors will appear from day one.

4. Batch traceability and compliance

In automotive, pharma, food, and aerospace, manufacturers must be able to trace every batch for recalls and audits. If batch records, where-used links, or batch classifications are not migrated correctly, you can lose traceability right after go-live. Regulated plants also need to revalidate the new system against standards such as GxP, IATF 16949, or FDA 21 CFR Part 11, which adds extra documentation and testing.

5. Shop-floor integration

Production relies on SAP connections to MES, machines, IoT platforms, and label printing systems. S/4HANA changes some data fields, output management, and APIs, so these interfaces may stop working and need to be remapped and retested. Even a short interface failure after go-live can block goods movements, create stock errors, and delay customer deliveries.

6. Cutover in 24/7 plants

Plants that run 24/7 can’t easily stop production for a 48 - 72 hour cutover. You may need to build extra stock in advance, prepare manual backup procedures, and carefully move open production orders and work in progress to the new system. The go-live date must also avoid peak seasons, product launches, and year-end closing.

Hitting roadblocks with your ECC to S/4HANA migration?

Talk to VNEXT’s SAP experts


Preparing for S/4HANA migration

Moving from SAP ECC to S/4HANA is one of the biggest IT projects a manufacturer can take on. It changes how the plant plans production, manages data, and runs daily operations, so success depends on solid preparation and strong cooperation between IT teams, plant managers, and business users.

The numbers show how easily these projects go off track. According to a study by Horváth, S/4HANA projects run about 30% over their planned timeline on average. Just 8% of companies finish on time, and more than 60% spend more than their original budget. In manufacturing, every delay can lead to production downtime, late shipments, and extra costs.

To help you avoid these problems, we've put together key preparation steps for an S/4HANA migration for manufacturers. They are based on SAP's official migration approach, results from real projects, and VNEXT's experience delivering SAP for manufacturing companies.

1. Audit your ECC situation before you commit a budget

A migration plan is only as good as your knowledge of the current system. Start with a full audit of your plant's SAP ECC setup, including custom code, interfaces, and the production processes behind them. In manufacturing, most surprises hide in custom PP, MM, QM, and WM programs.

  • Run SAP Readiness Check and the Simplification Item Check as a first step
  • Build an inventory of Z-programs, user exits, add-ons, and interfaces by module
  • Compare custom scheduling and quality programs with standard PP/DS, MRP Live, and EWM
  • Sort shop-floor connections (MES, PLCs, label printers, EDI) into keep, adjust, or replace
  • Ask production, quality, logistics, and finance leads to rank their business priorities

2. Set clear goals and choose the right migration approach

Decide what the plant should gain from S/4HANA before you decide how to get there. Link the project to production results, then pick Greenfield, Brownfield, or Bluefield based on how much ECC logic is still worth keeping.

  • Define targets such as shorter planning cycles, higher inventory accuracy, or better on-time delivery
  • Choose your deployment model: on-premise, RISE with SAP private cloud, or hybrid
  • Staff the project with SAP architects, IT specialists, and super users from each plant
  • Include licenses, infrastructure, consulting, training, and a contingency reserve in the budget
  • For multi-plant companies, agree on the rollout sequence and a pilot site early

3. Run the project on SAP Activate

SAP Activate is SAP's recommended delivery framework, built around six phases: Discover, Prepare, Explore, Realize, Deploy, and Run. Its formal checkpoints between phases keep late changes in check, which is one of the most common causes of cost overruns.

  • Use the Discover phase to test S/4HANA features against your plant's needs
  • Run fit-to-standard workshops in Explore with planners, quality, and warehouse teams
  • Approve the scope and design formally before moving to the Realize phase
  • Track every change request against the agreed budget and timeline
  • Plan the Run phase early to cover support and continuous improvement after go-live

4. Clean your manufacturing master data early

In terms of data, BOMs, routings, work centers, production versions, and batch records need the most attention, along with the move to the Business Partner model, where separate customer and vendor records for the same company are merged into one.

  • Begin data cleansing 12–18 months ahead of the planned go-live
  • Name a responsible owner for materials, production, quality, procurement, and finance data
  • Fill in missing production versions, retire unused BOMs and routings, and resolve partner duplicates
  • Plan several trial data loads, since some errors only show up during a real migration

5. Plan more testing than you think you need

Testing is the phase most teams underestimate. An ISG survey found that 58% of companies would have chosen a longer schedule or larger budget in hindsight, mainly because of short testing windows.

  • Introduce test automation while the system is being built
  • Complete at least three integrated test cycles before user acceptance testing
  • Test full flows from sales order and MRP to production confirmation, quality release, and shipping
  • Check MES, machine, and label printing interfaces with real orders and volumes
  • Stop all new changes 4 - 6 weeks before go-live

6. Protect production during cutover

In a factory, go-live is an operational event as much as a technical one. Lines must keep running, customer orders must ship, and inventory must stay correct, so plant managers should own the cutover plan together with IT.

  • Rehearse the full cutover at least twice and record the duration of every step
  • Build safety stock ahead of go-live to cover any downtime
  • Define how open production orders, WIP, and goods in transit move to the new system
  • Schedule go-live away from seasonal peaks, product launches, and fiscal year-end
  • Set go/no-go criteria with leadership and plan on-site hypercare for the first weeks

7. Bring plant teams into the change early

People accept a new system more easily when they help shape it. Involve planners, quality engineers, and warehouse leads from the first workshops, and tailor the message: leaders want business value, while operators want simpler screens and fewer steps.

  • Secure executive sponsorship before the project kicks off
  • Name process owners with the authority to sign off on system design
  • Start role-based Fiori training for planners, operators, and inspectors before final testing
  • Capture the know-how of long-serving staff about why ECC was configured the way it is
  • After launch, monitor user adoption, system availability, and error rates by plant

"In manufacturing, the plants that migrate successfully are the ones that start early. When companies wait too long, they pay more and end up cutting corners on master data cleanup and shop-floor training, and that shows up later as planning errors and frustrated operators. Take the time to understand how your ECC system really supports production, decide which custom programs still add value, and use the migration to improve how your plant plans, builds, and ships, not just to replace one system with another."

Long Ho - SAP expert

How much does an ECC to S/4HANA migration cost?

The cost of transition varies. For a single plant with mostly standard processes, the budget usually ranges from $100,000 to $500,000. Mid-sized manufacturers with several plants often spend $500,000 - 1 million. Large enterprises with many sites, heavy customization, and strict compliance requirements can exceed $2 million.

Five factors shape the final budget:

  • Migration approach. Brownfield is usually the cheapest and fastest, Greenfield costs the most, and Bluefield falls in between.
  • Number of plants. Each plant adds processes, users, data, and interfaces to migrate and test.
  • Custom code volume. Every custom PP, MM, QM, or WM program must be kept, rebuilt, replaced, or retired.
  • Data cleanup. Outdated BOMs, routings, and duplicate supplier records add time and extra test migrations.
  • Implementation partner. Manufacturing experience helps avoid rework in scoping, testing, and cutover.

That’s why two manufacturers moving to the same S/4HANA system can get very different quotes. A plant with standard PP and few interfaces needs far less work than one with dozens of custom scheduling programs, WM-to-EWM migration, and MES connections at every site.

How long does an ECC to S/4HANA migration take?

For a single plant with a Brownfield conversion, the migration usually takes 9 to 12 months. Greenfield projects take longer, often 12 to 18 months for one plant, because processes are redesigned from scratch. Mid-sized manufacturers with several plants typically need 12 to 24 months, while large enterprises with many sites and phased rollouts should plan for 2 to 4 years from assessment to the last go-live.

Timelines grow with the same factors that drive cost: custom code volume, master data quality, the number of shop-floor integrations, and compliance validation in regulated industries. Data cleanup alone often needs to start 12–18 months before go-live, and testing is the phase most often cut short. Plants should also leave room for cutover planning around production peaks and for several weeks of hypercare after launch.

Final thoughts

For manufacturers, the hardest part of an SAP S/4HANA migration is keeping production running while modernizing the system behind it. With ECC mainstream maintenance ending in December 2027 and extended support running to 2030, the question is no longer whether to migrate, but which plants and modules to move first. A good first step is to count your custom programs in PP, MM, QM, and WM. If you have more than 100, plan for a phased rollout of 24 - 36 months.

VNEXT is an SAP Gold Partner with experience in manufacturing processes. We handle the full migration, from readiness assessment and custom code remediation to data cleanup, testing, and cutover planned around your production schedule. Book a free S/4HANA readiness assessment to get a clear view of your scope, timeline, and next steps.

Long Ho
Long Ho

Project Manager | ERP Solutions Consultant | SAP Expert

Long Ho heads enterprise solution delivery at VNEXT, focusing on helping Japanese clients modernize their core business processes across SAP, ERP, manufacturing, logistics, professional services, and other business systems. With over 7 years of experience, he has grown from a full-stack developer into a Project Manager and Tech Lead, combining deep technical expertise with strategic leadership and client communication. Responsible for overseeing enterprise-scale projects of varying complexity, Long leads teams of up to 20 engineers through requirements analysis, architecture, development, and quality assurance, delivering tailored solutions that stay on schedule and within budget. He puts specific focus on aligning each solution with client objectives, mentoring developers and raising engineering standards along the way. Long also works with AI-assisted engineering, holding a Cognitive Engineering Level 6 certification, and integrates AI tools into his team's development workflow to strengthen how they build.

Let's talk

Ready to get results?
Our team is here to help.

  • AI Development
  • Custom Software Development
  • Mobile Application Development
  • Web Application Development
  • Cloud Development
  • Blockchain
  • Embedded Software
  • Enterprise Software
  • SAP
  • CRM
  • Data & Analytics
  • IT Outsourcing
  • Offshore Development Center
  • Dedicated Development Team
  • Staff Augmentation
  • I'm not sure / I need consultation
  • Automotive
  • Education
  • Energy & Environment
  • Enterprise Software & DX
  • Entertainment & Media
  • Finance
  • Gaming
  • Healthcare
  • Manufacturing
  • Professional Services
  • Retail
  • Transportation & Logistics
  • Travel & Hospitality
  • Others
